World’s Longest Immersed Tunnel Takes Shape Under the Baltic Sea

Byjefy jean

16 July 2026

For passenger transport, this means shorter journey times and improved reliability. For freight movement, the tunnel could strengthen rail-based logistics between Scandinavia and the rest of Europe. By improving the competitiveness of rail, the project supports broader European goals around modal shift, lower-emission transport and more resilient cross-border supply chains.

Immersed Tunnel Construction: How the Baltic Sea Tunnel Is Being Built

This means large reinforced concrete tunnel elements are manufactured in a controlled factory environment, floated to the offshore alignment, and then lowered into a pre-dredged trench on the seabed. Once positioned, the elements are connected underwater and progressively backfilled to form the permanent undersea structure.

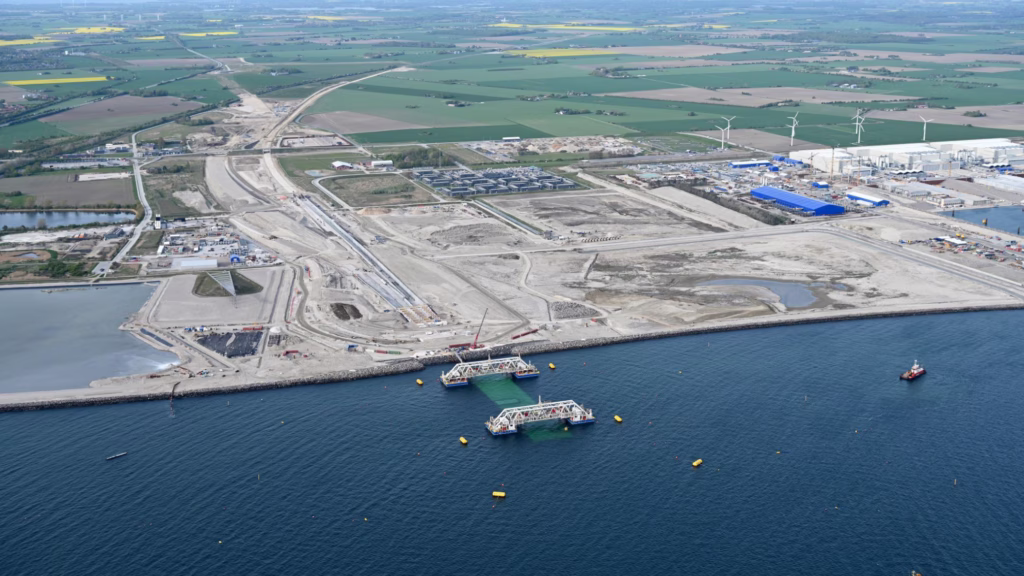

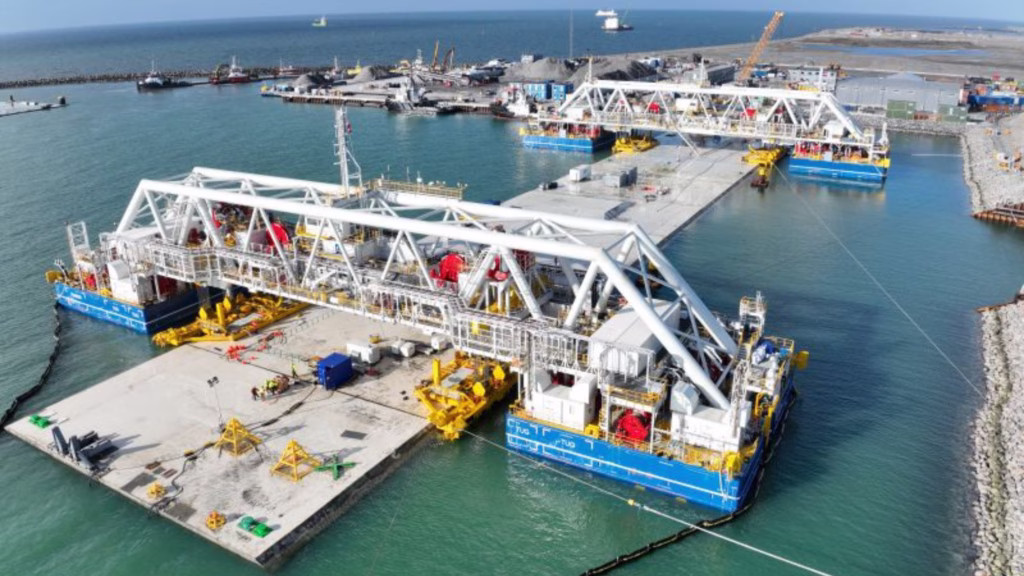

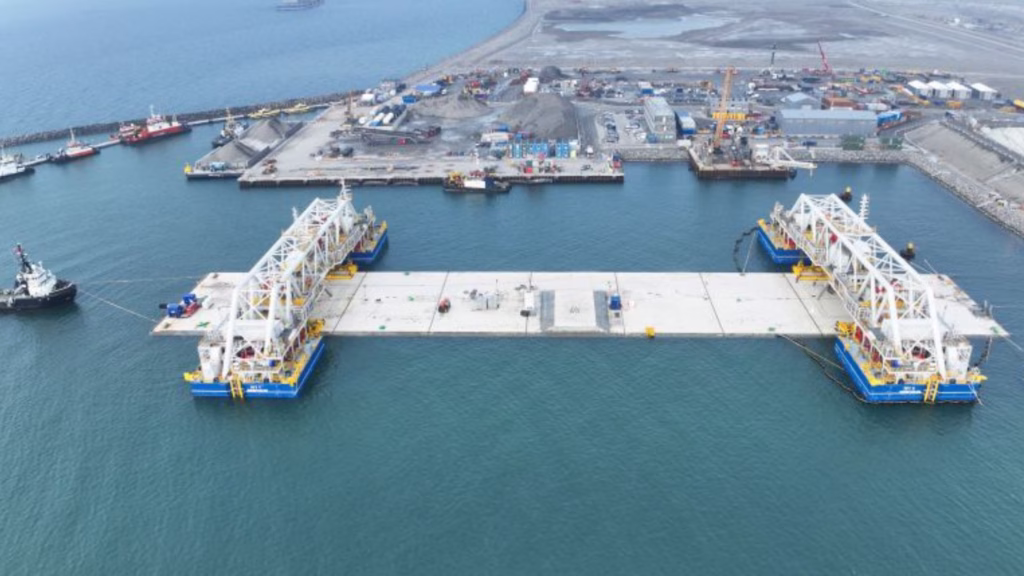

The tunnel elements are being produced at a purpose-built facility in Rødbyhavn, Denmark. Each element is cast, fitted with internal systems where possible, transported by tugboats and immersion equipment, and then placed underwater with high positional accuracy. In May 2026, Femern A/S confirmed that the first 217-metre tunnel element had been successfully placed on the seabed, marking a major transition from fabrication-led progress to permanent offshore installation.

The Scale of the World’s Longest Immersed Tunnel

The scale of the Fehmarnbelt prefabrication programme is exceptional. The tunnel is composed of 89 large concrete elements, each approximately 200 metres long. These elements are comparable in size to major marine structures and require careful handling at every stage of production, transport and installation.

Each tunnel segment must be floated, ballasted, submerged and aligned inside a trench roughly 40 metres below the sea surface. This process demands strict control of buoyancy, weather windows, seabed preparation, marine logistics and geodetic positioning. In immersed tunnel construction, even small deviations can create major downstream issues.

A misalignment at a tunnel joint can affect waterproofing, internal fit-out, long-term settlement performance and operational safety. For this reason, precision measurement, dedicated immersion vessels, controlled jointing and progressive backfilling are not secondary execution details. They are central to the structural reliability of the finished tunnel.

Durability Challenges in a Marine Tunnel Environment

In a tunnel of this type, durability cannot be treated as a one-time construction requirement. It becomes a permanent asset-management issue. The structure must remain serviceable for decades while operating under demanding marine and transport conditions. This is why quality control, monitoring systems and maintenance planning are embedded into the project from the beginning.

Integrated Road and Rail Tunnel Design

The final tunnel configuration will carry both motorway and rail traffic. It includes separate road and rail tubes, along with a dedicated service corridor for technical installations, inspection and emergency response. This separation improves operational safety by allowing road traffic, rail systems, ventilation, drainage, fire protection, power supply and communications to be managed through dedicated spaces.

For a long undersea transport asset, this approach is essential. The Fehmarnbelt tunnel is not simply a concrete structure below the seabed. It is a continuously monitored transport system, with civil engineering, mechanical systems, electrical infrastructure, signalling, communication networks and emergency functions integrated into a single operational asset.

German Rail Upgrades and Cross-Border Connectivity

This includes double tracking, electrification, new structures, modern train protection systems and improved alignment capability. Without these supporting works, the tunnel could become a high-capacity link connected to constrained networks. The project therefore demonstrates an important lesson in megaproject planning: a major civil structure delivers its full value only when the surrounding transport system can absorb and distribute the movement it creates.

A New Benchmark for European Infrastructure

The Fehmarnbelt Fixed Link is more than the world’s longest immersed tunnel. It is a demonstration of how industrialised construction, marine engineering, transport planning and international governance must work together on a single programme.

Its success will be measured not only by the installation of the final tunnel element, but by the performance of the finished corridor. If delivered as planned, the Fehmarnbelt tunnel will provide a safer, faster and more resilient connection between Denmark, Germany and the wider European transport network.
